19 Towers Across the California Hills
When you're building a wind farm, wind is kind of the point—until you're trying to fly a blade hundreds of feet in the air.

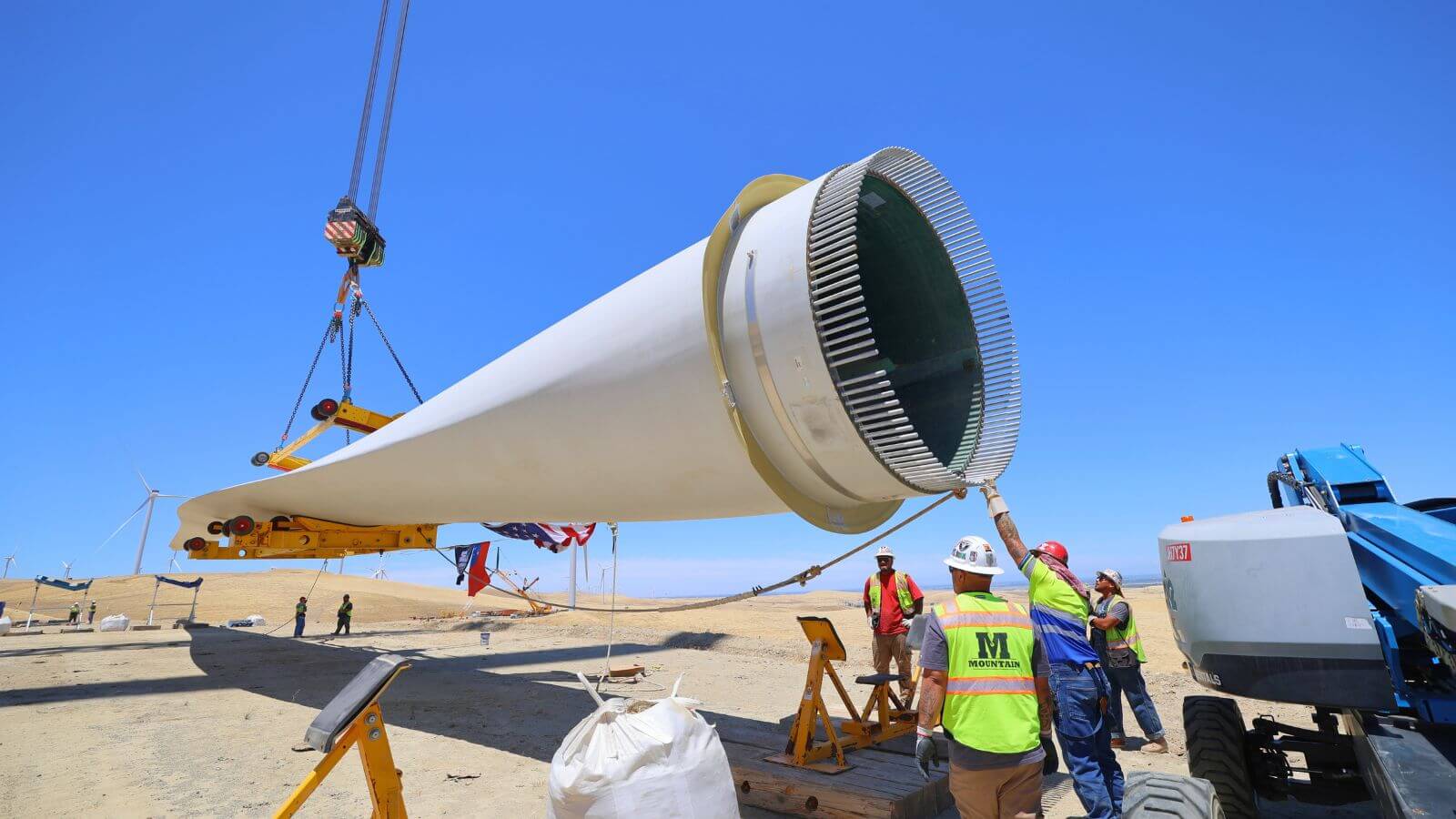

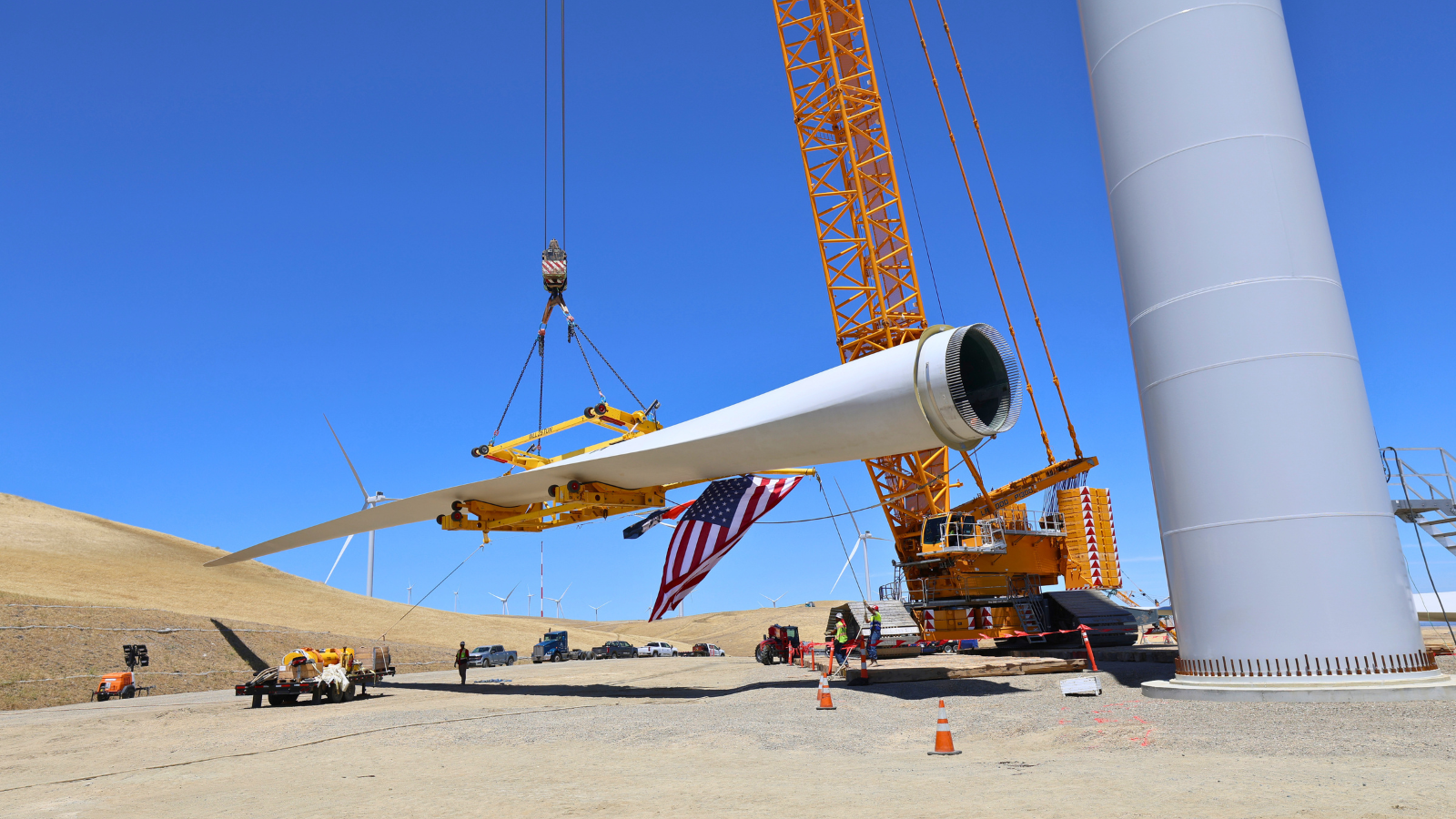

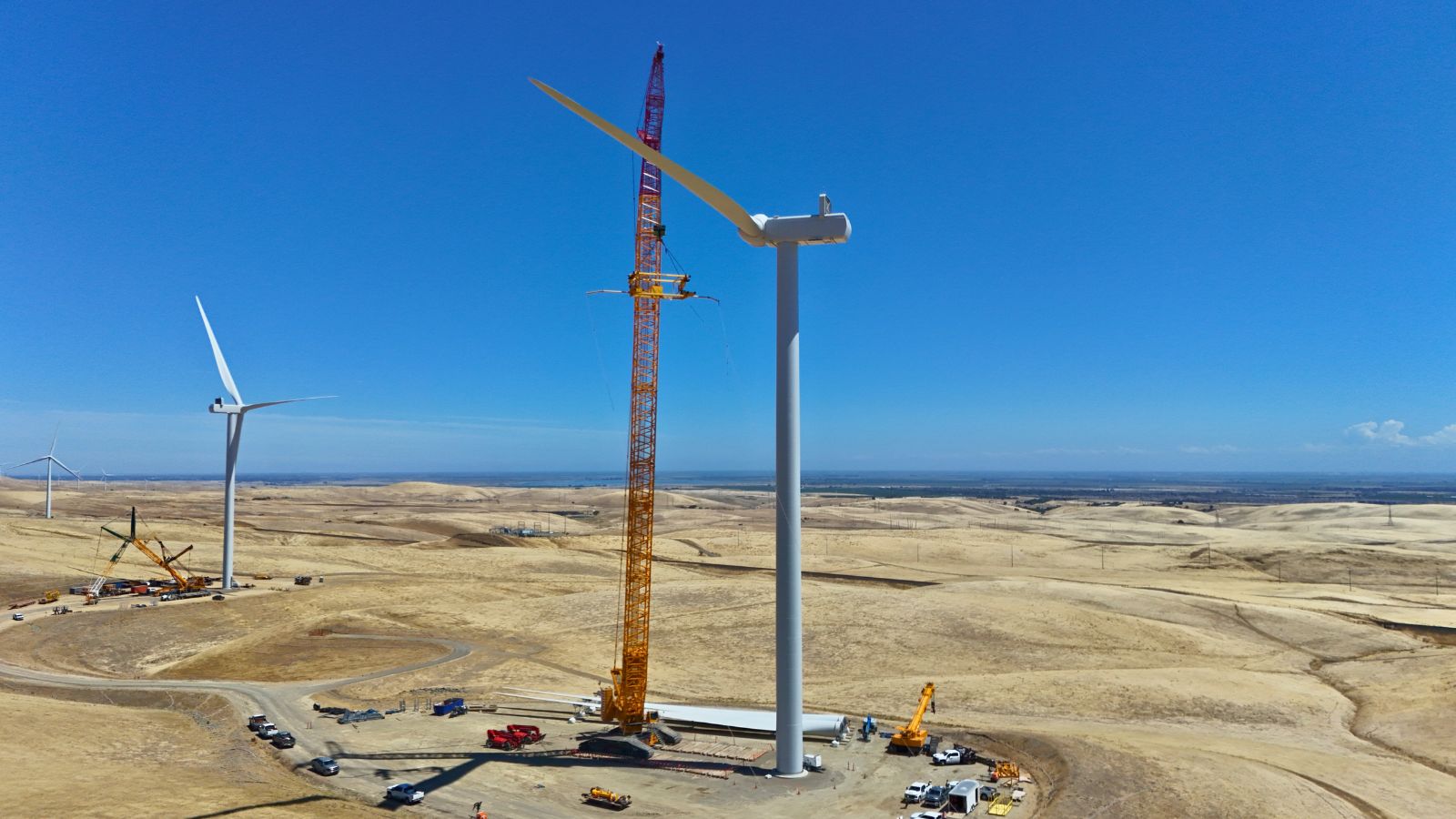

At the MulQueeney wind project in California, Mountain recently reached a major milestone with the completion of the final turbine in a 19-tower Vestas V136 project. Spread across the California hills, the turbines stand approximately 261 feet to the top flange and were erected using a single-blade installation method, requiring each blade to be individually lifted and precisely positioned at height.
Getting all 19 towers standing required a combination of heavy lifting equipment, careful coordination and the ability to adapt to whatever the jobsite had in store.
Meeting the Challenge

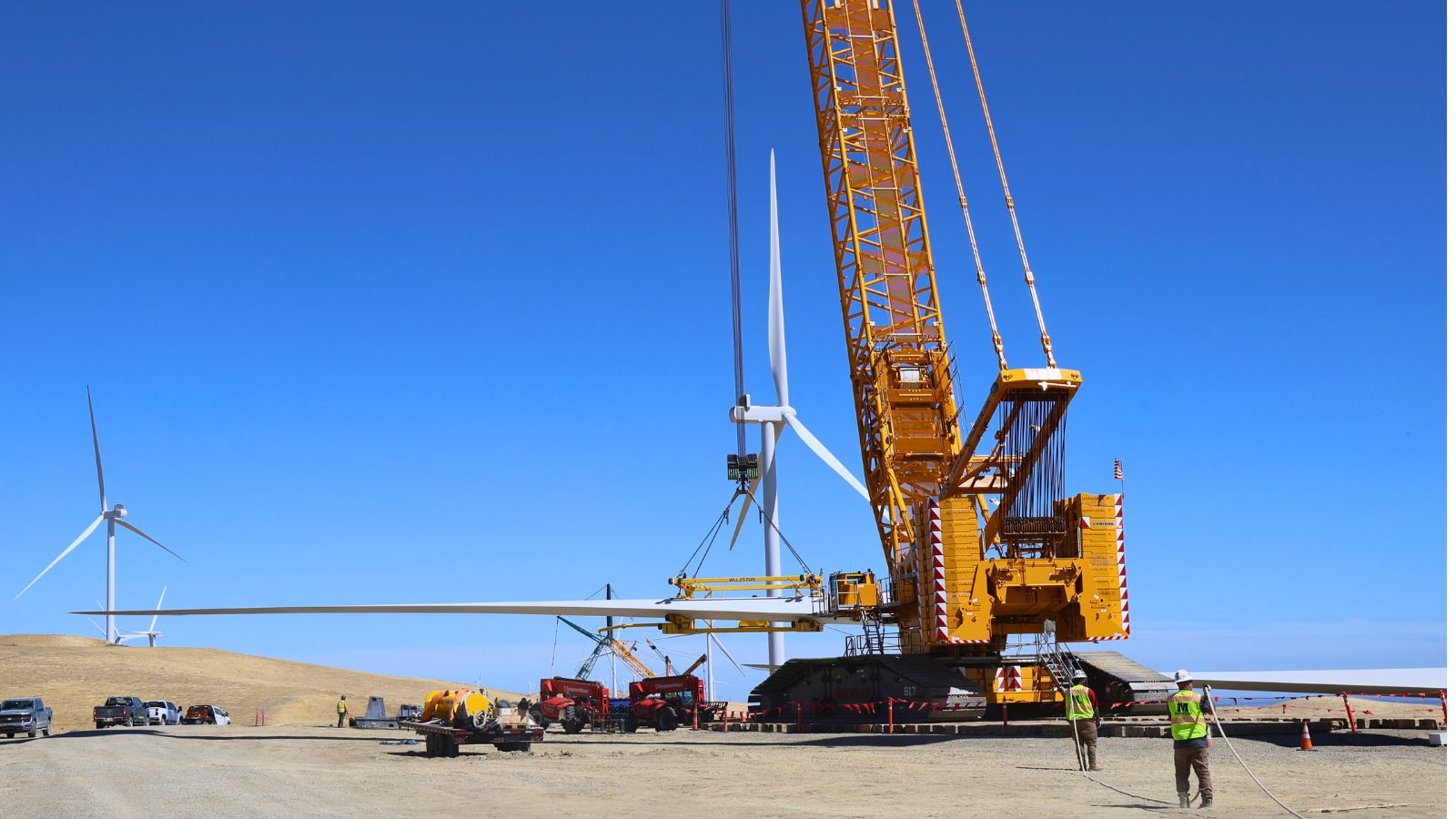

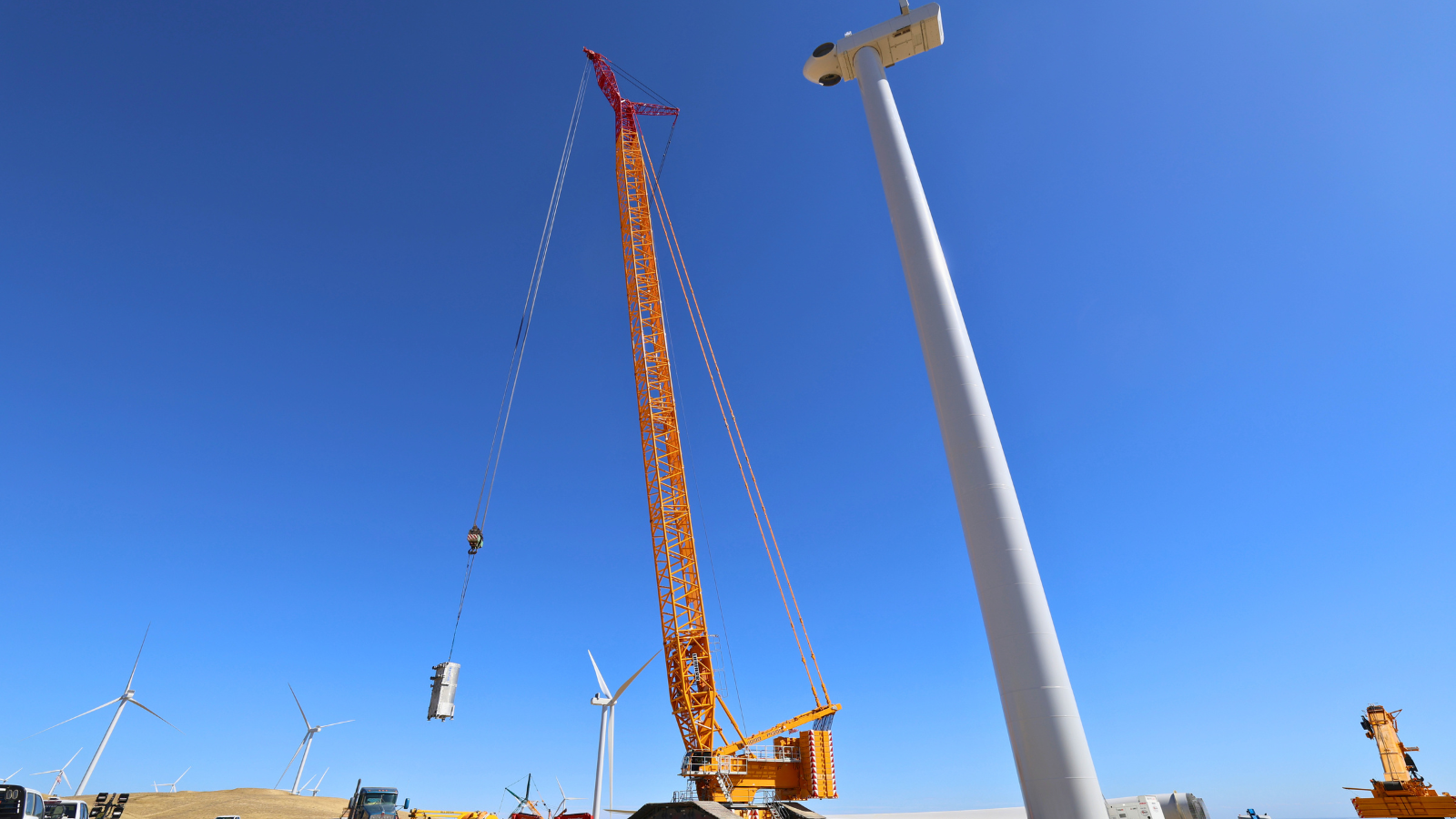

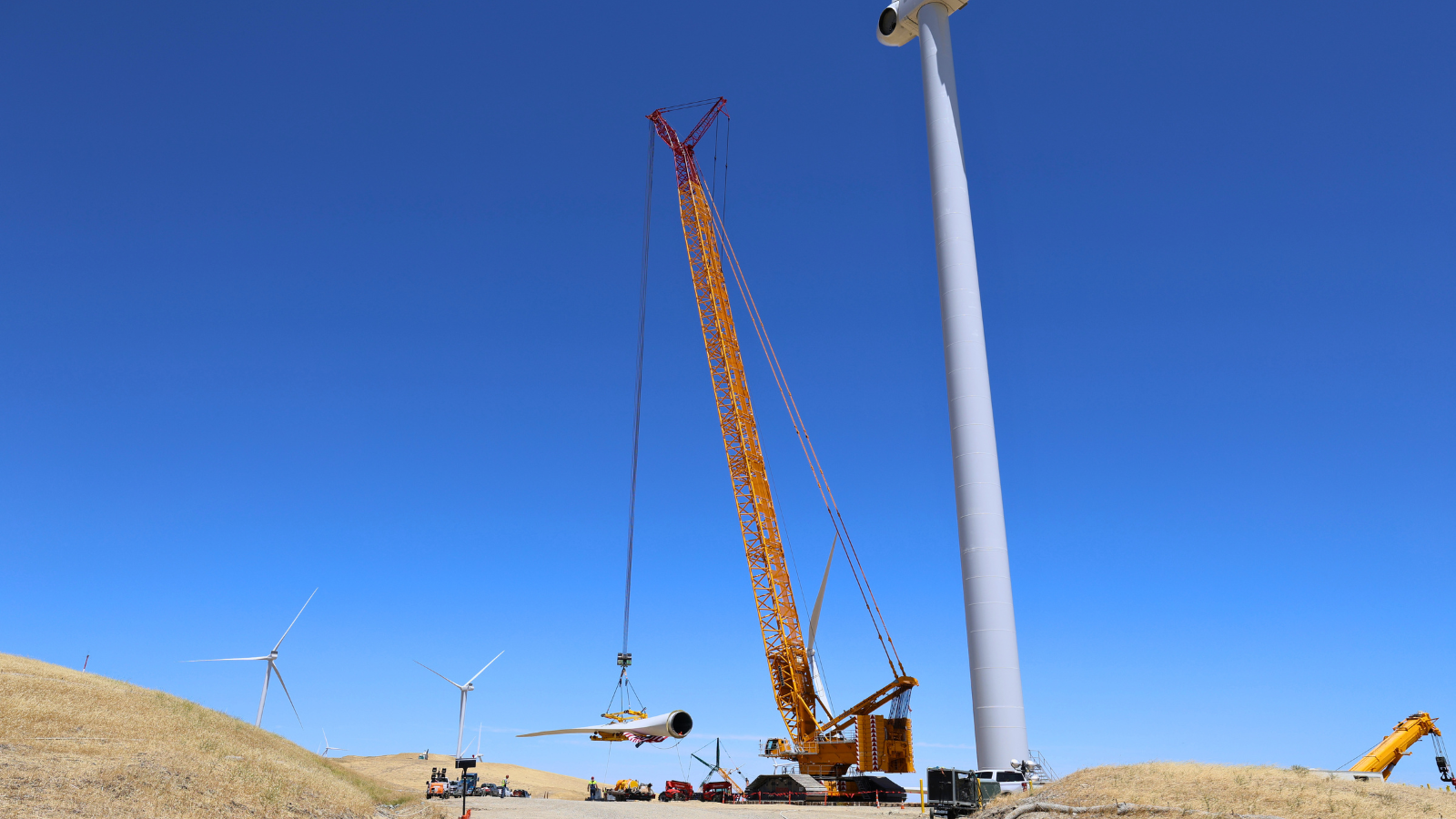

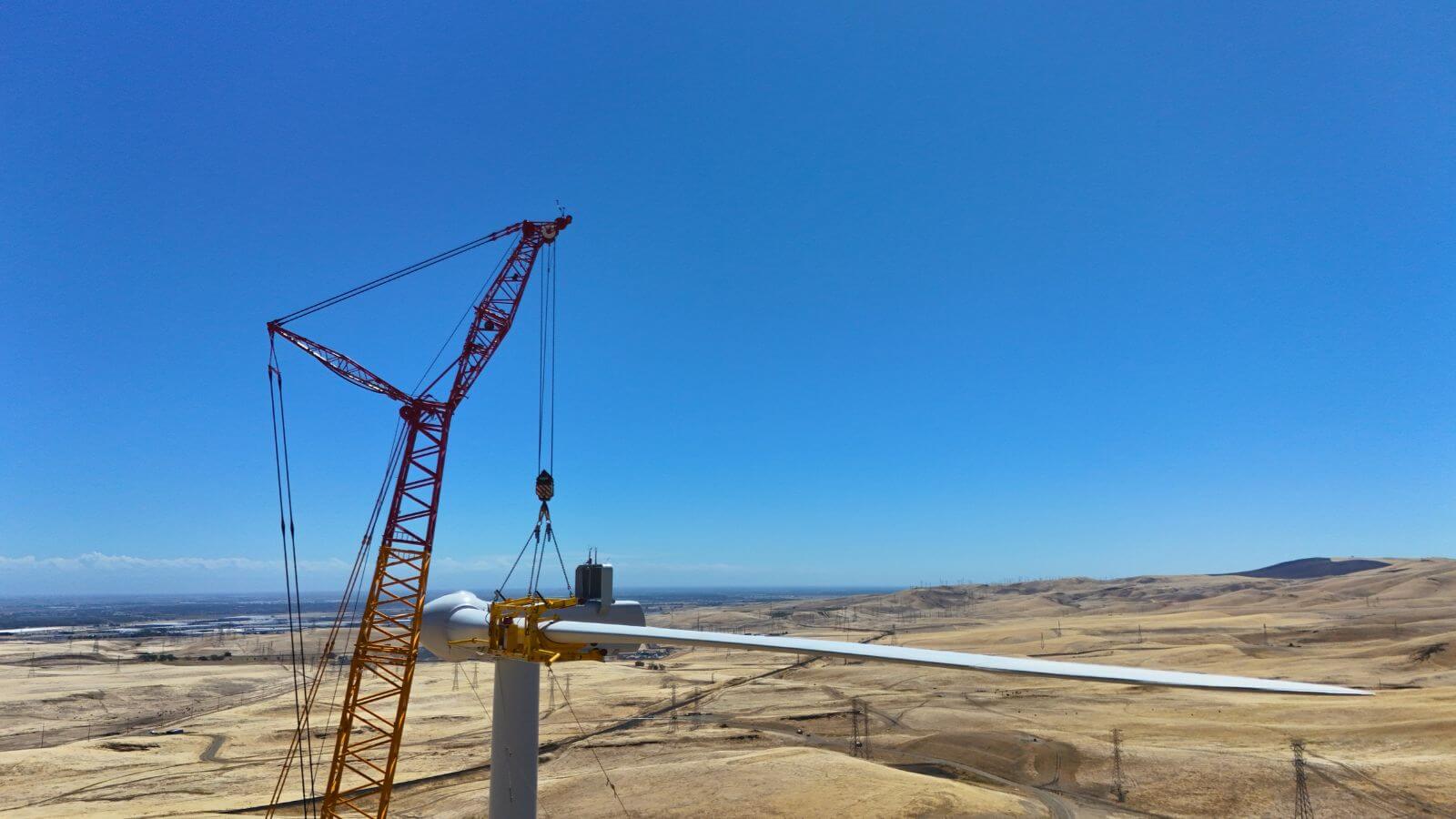

The Liebherr LR 11000 served as the primary erection crane, including flying the three blades on the final tower. An LTR 1220 supported operations as a tail crane, while the LTM 1750-9.1, RT cranes and additional support equipment helped tackle work throughout the site.
But on a wind farm, sometimes the biggest challenge is exactly what you're there to harness: the wind.

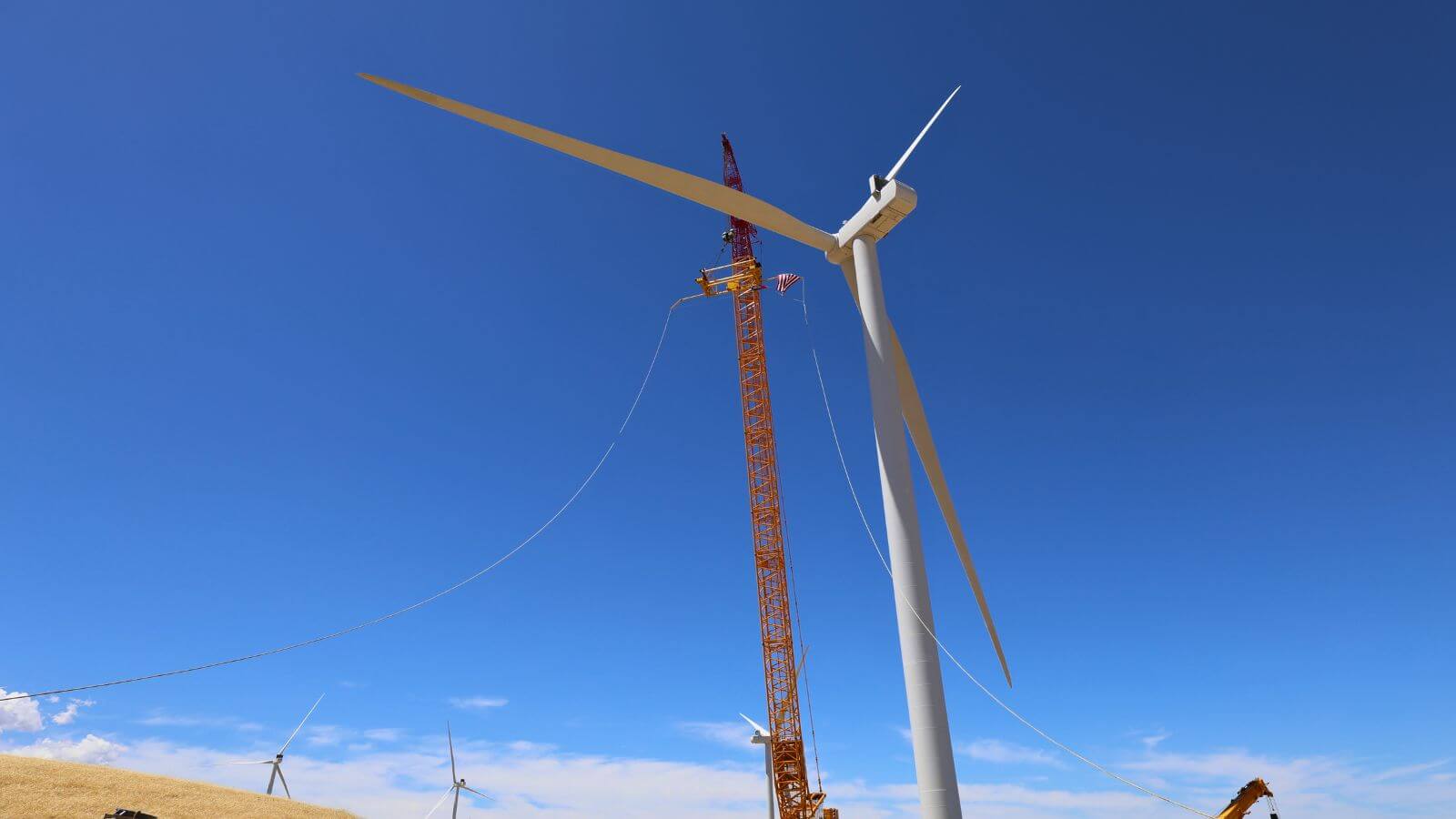

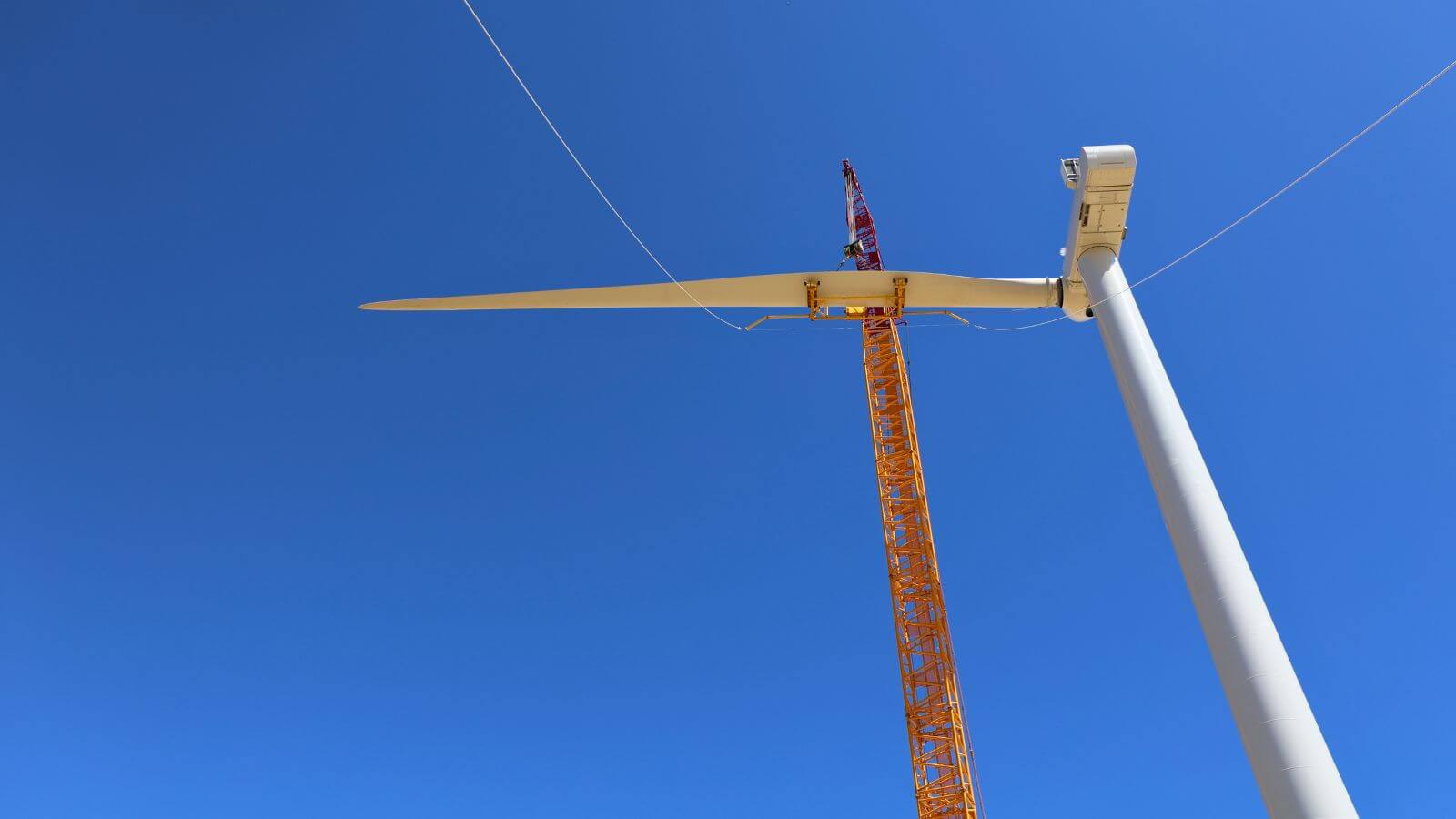

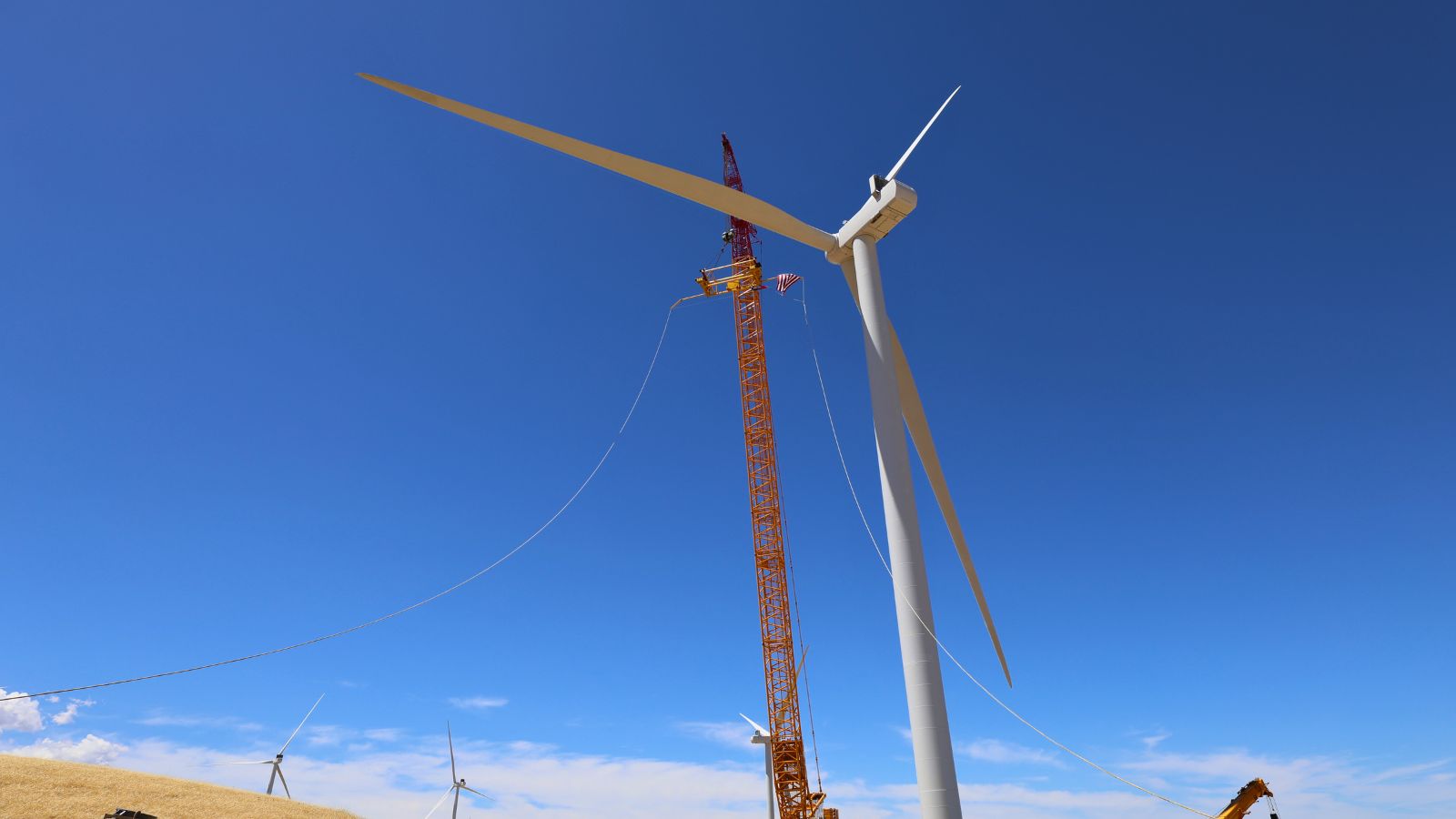

High winds created recurring delays during erection, particularly when flying blades. Crews had to work within acceptable weather windows, adjusting operations as conditions changed while continuing to move the project forward.
The California terrain presented its own challenges. With turbines positioned at different elevations throughout the site, moving equipment and executing lifts required planning that accounted for the unique conditions at each tower location.
The local wildlife kept things interesting, too. A professional rattlesnake handler was kept on site to safely remove rattlesnakes that made their way into active work areas. When one was spotted, work in the area stopped until the handler could safely relocate it—an unusual but necessary part of keeping operations moving safely in the California hills.
Between varying terrain, unpredictable winds and the occasional rattlesnake, McQueeney was a project that kept crews on their toes from start to finish.
One Blade at a Time

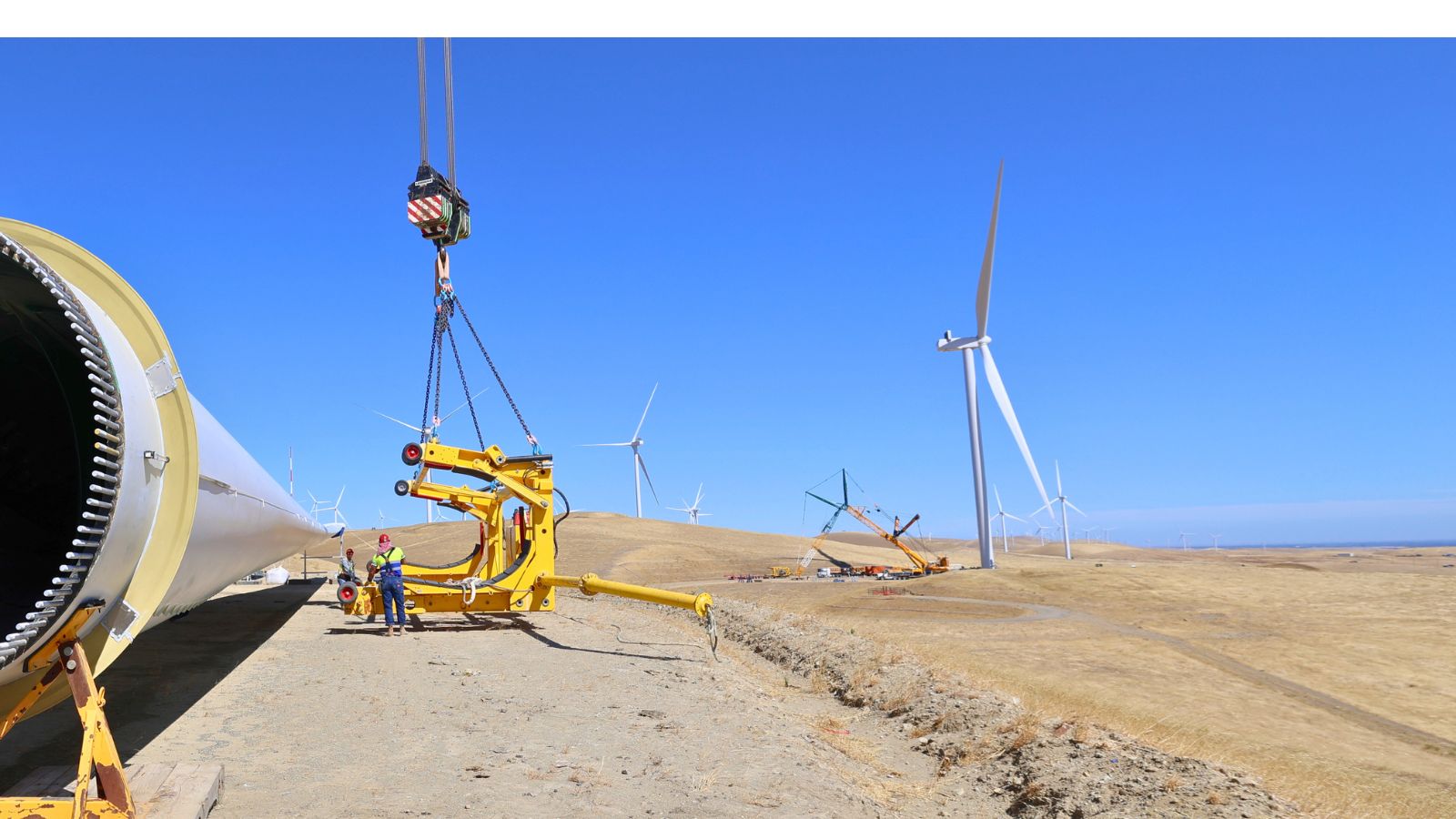

At peak activity, approximately 110 to 120 people were working across the MulQueeney site. Coordinating that many people, multiple cranes and support equipment across 19 turbine locations made communication and planning an important part of keeping the project moving.
The installation of the final three blades marked the completion of the project's primary erection scope, but work wasn't quite finished. The LTM 1750 remained on site for additional work on another turbine, including removing the blades and hub to complete drivetrain alignment work before putting the turbine back together.
A Strong Finish
Wind, terrain and the unexpected all brought their share of challenges to MulQueeney. Completing a project of this scale required the right equipment, detailed planning and the ability to adjust when conditions changed.

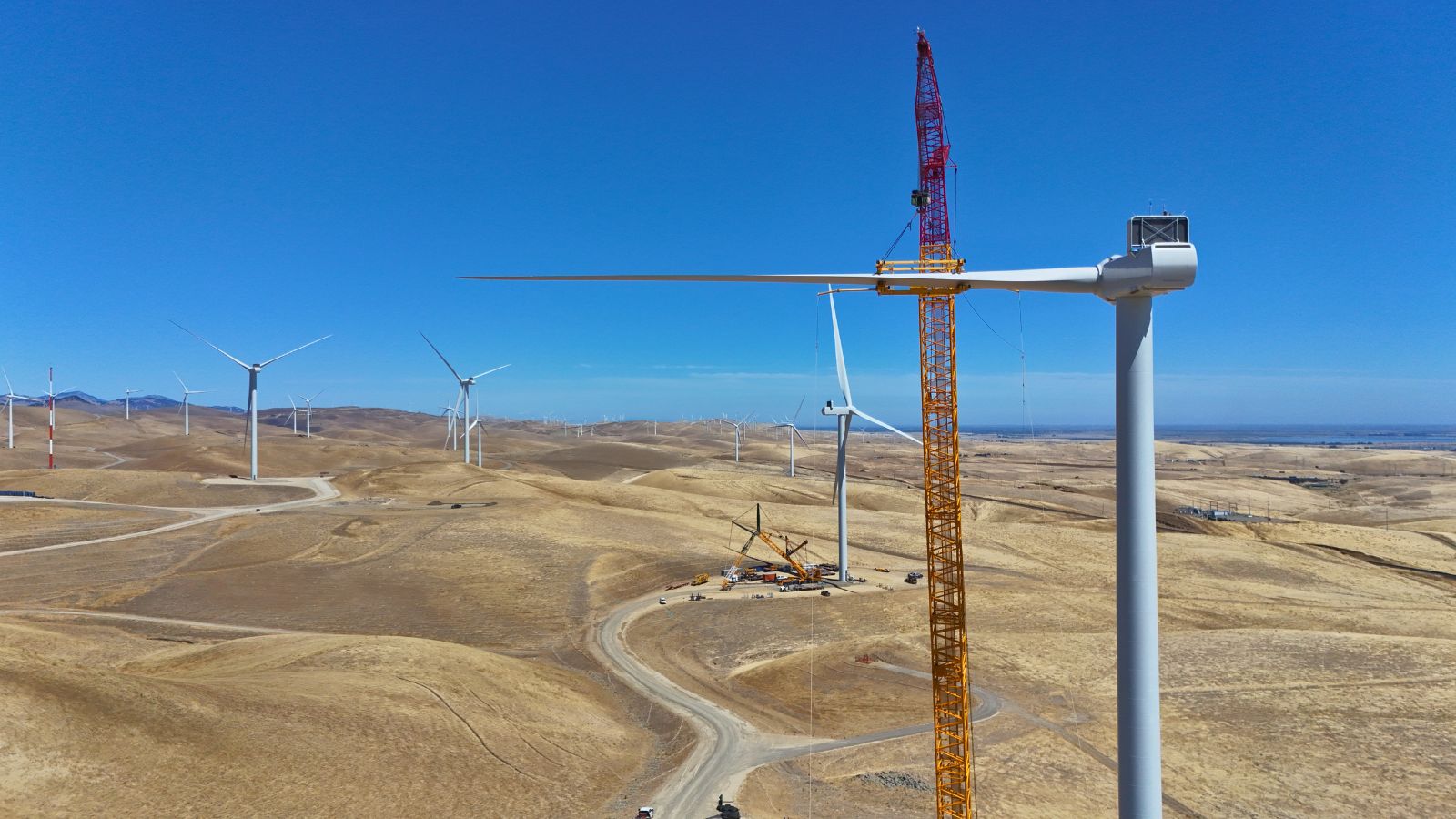

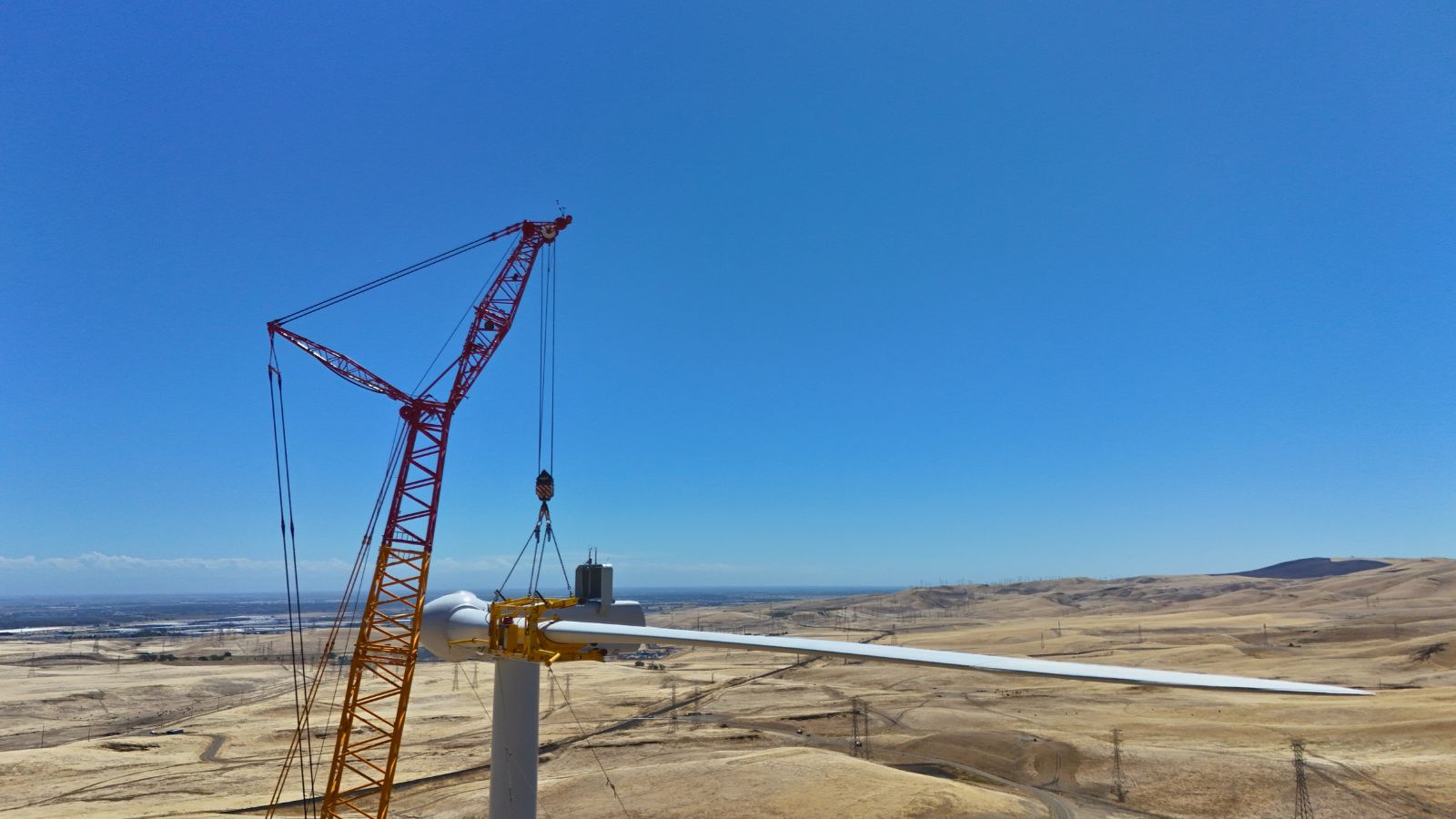

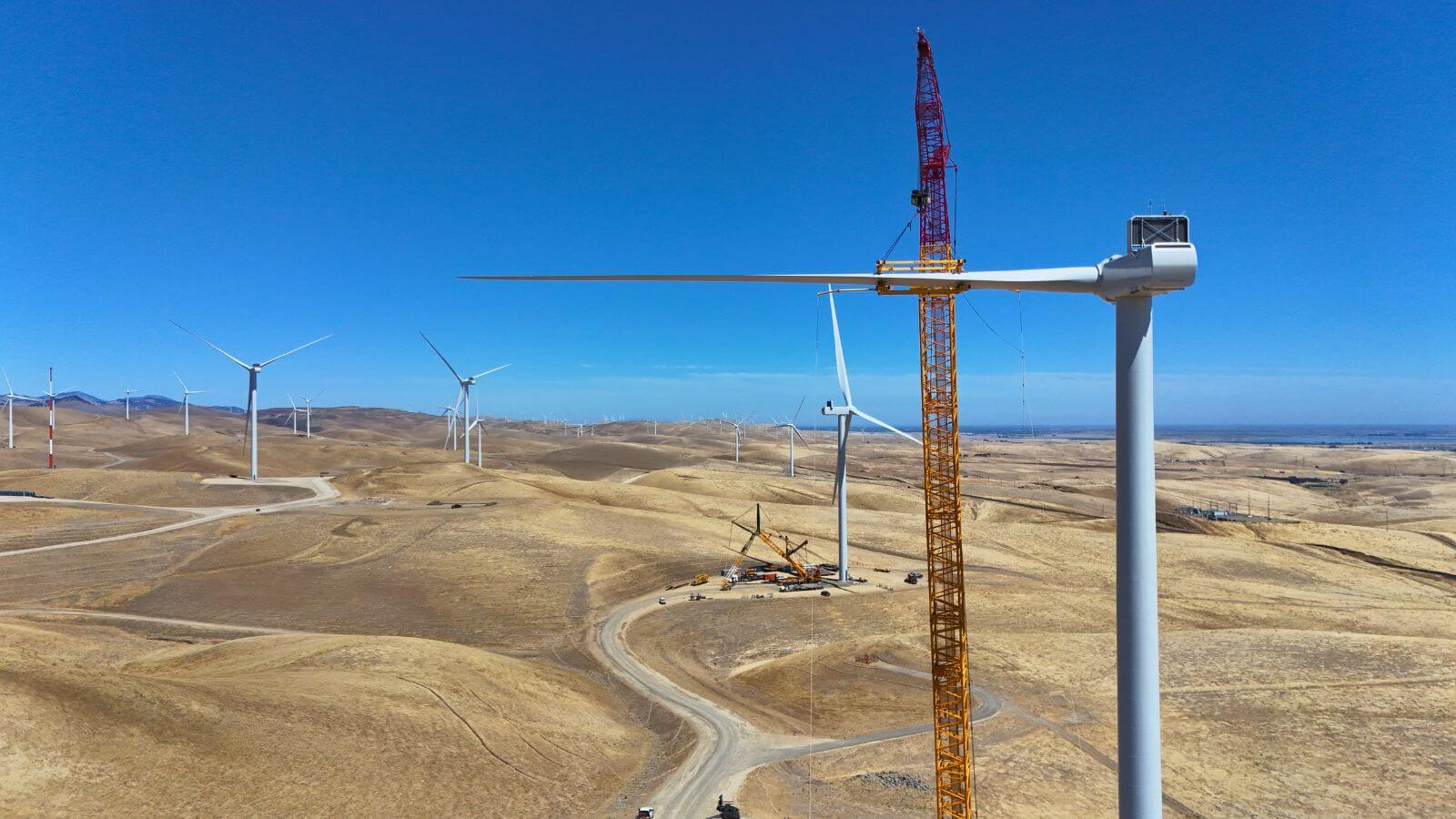

After 19 towers and countless lifts, watching the final blades rise into place represented the culmination of months of work across the California hills.
For a project built around the power of wind, it's only fitting that the wind kept things interesting until the very end.
But in the end, Mountain got the job done—one tower, one lift and one blade at a time.
